Getting Started as a Budget Manager

Everything a Budget Manager needs to get oriented in Mosaic — the financial terms, the workflows that connect planning to profitability, and where the financial data lives.

Overview

Budget Manager is the standard access level for principals, PMs with financial oversight, and accounting staff. It includes everything a Work Planner can do, plus the financial layer: dollar amounts, bill rates, cost rates, and the Budget space on projects. Where a Work Planner sees hours and percentages, you will also see the dollars.

Start here when you want to:

  • Set project budgets and monitor spending against them

  • Compare planned time to spent time by phase and by member

  • See bill rates and cost rates when making staffing decisions

  • Understand how the schedule your PMs build drives project financials

  • Pull budget-based reports for leadership

info icon
Note: Like Work Planner, Budget Manager access can be set to view-only or edit within the Budget space. Your admin controls this.

What You Can Access

  • Everything at Work Planner level — Home, Projects, Workload, Planner

  • Budget tab on projects — Full financial view including dollar amounts

  • Budget-based reports

  • Bill rate and cost rate visibility — Including the bill rate display toggle in Workload

  • Scope tab on projects — Advanced scope management

warning icon
Cost Rate is only visible if your Account has them enabled and if your Admins give you access to this visibility.

Important Terms

Term

What it means to you:

Phase

The unit budgets attach to. Budgets, work plans, and spent time all roll up through phases — not through the project directly

Sub-phase

A nested phase. Budget rolls up into its parent phase

Milestone

A single date with no budget and no hours. Milestones never affect financials — this is the key distinction from a phase

Work Plan

Scheduled time for a member on a phase. Work plans are what drive planned cost and planned revenue

Planned vs. Spent

Planned = what work plans allocate. Spent = actual time synced from your ERP. The gap between them is your early warning.

Bill Rate

What the member's time bills at. Visible only to Budget Managers and Admins, and requires an extra click to reveal in Workload

Cost Rate

The organization’s cost for a person per hour, including wages, benefits, and overhead expenses.

Burn Rate

How quickly a phase or project is consuming its budget relative to the schedule

Tentative Plan

A plan flagged as tentative. Confirm whether these are included in the budget bar calculation before relying on it — see Accuracy Check

Scope

Advanced project scope management, gated to Budget Managers.

Important Workflows

1. Build member estimates, then build work plans from what remains

Set estimated hours per member per phase in the Budget modal. Work plans draw against those estimates, and Mosaic tracks what is left.

Add members to phases

  1. Open the Budget modal from the Budget icon button.

  2. On the Time tab, expand a phase or work category.

  3. Click + Member, then choose Add Members or Add Open Roles.

  4. Check every phase, subphase, or work category that person belongs on.

Rates appear beneath each name and come from organization settings. They can be overridden for this project. Use Add Open Roles when you know the role but not the person. Assigning the role later transfers its work plans and estimated hours.

Enter estimated hours

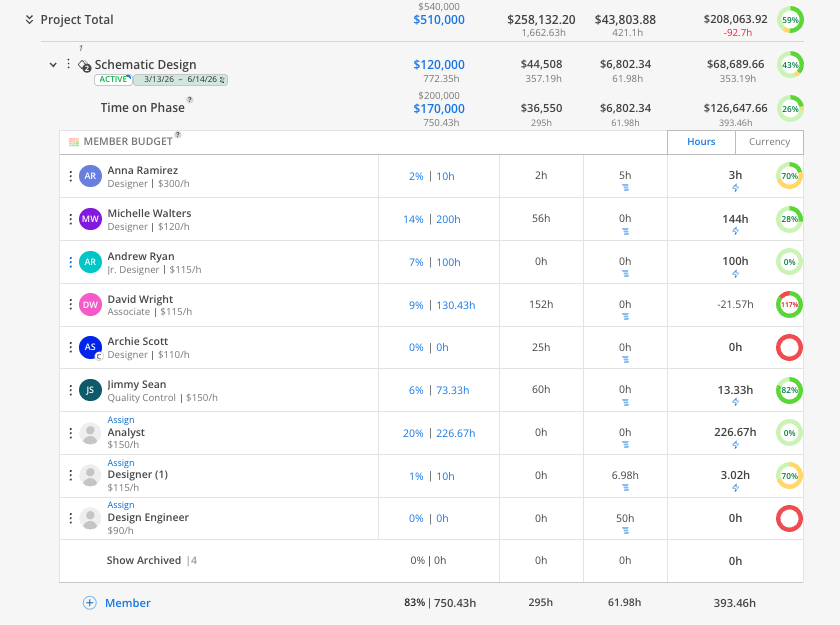

  1. Enter estimated hours for each member on the phase or work category.

  2. Mosaic calculates the dollar amount from that member's rate.

  3. Estimates roll up into work category, phase, and project totals.

Turning on Scope Estimate makes scope hours the source of member estimates and sets the Time tab fields to read-only. Decide this before you start estimating.

Build work plans against the remaining estimate

  1. In Workload or Planner, open the work plan modal on the member's row.

  2. Select the project and the phase holding the estimate. Estimated hours appear beneath the member's name.

  3. Click into the total hours field, then click the lightning bolt to pull in the remaining hours.

  4. Set the date range and click Create.

The remaining figure accounts for hours already planned and spent, so scheduling in stages works cleanly.

👉 Member Budget Estimate

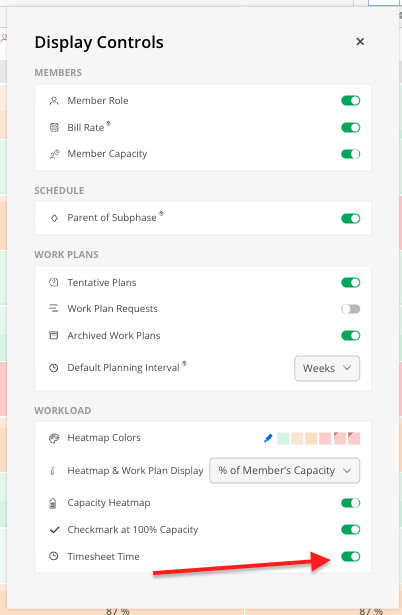

2. Enable your Display Settings when in the Workload Space

  1. In Workload Space, open the display toggles in the top right.

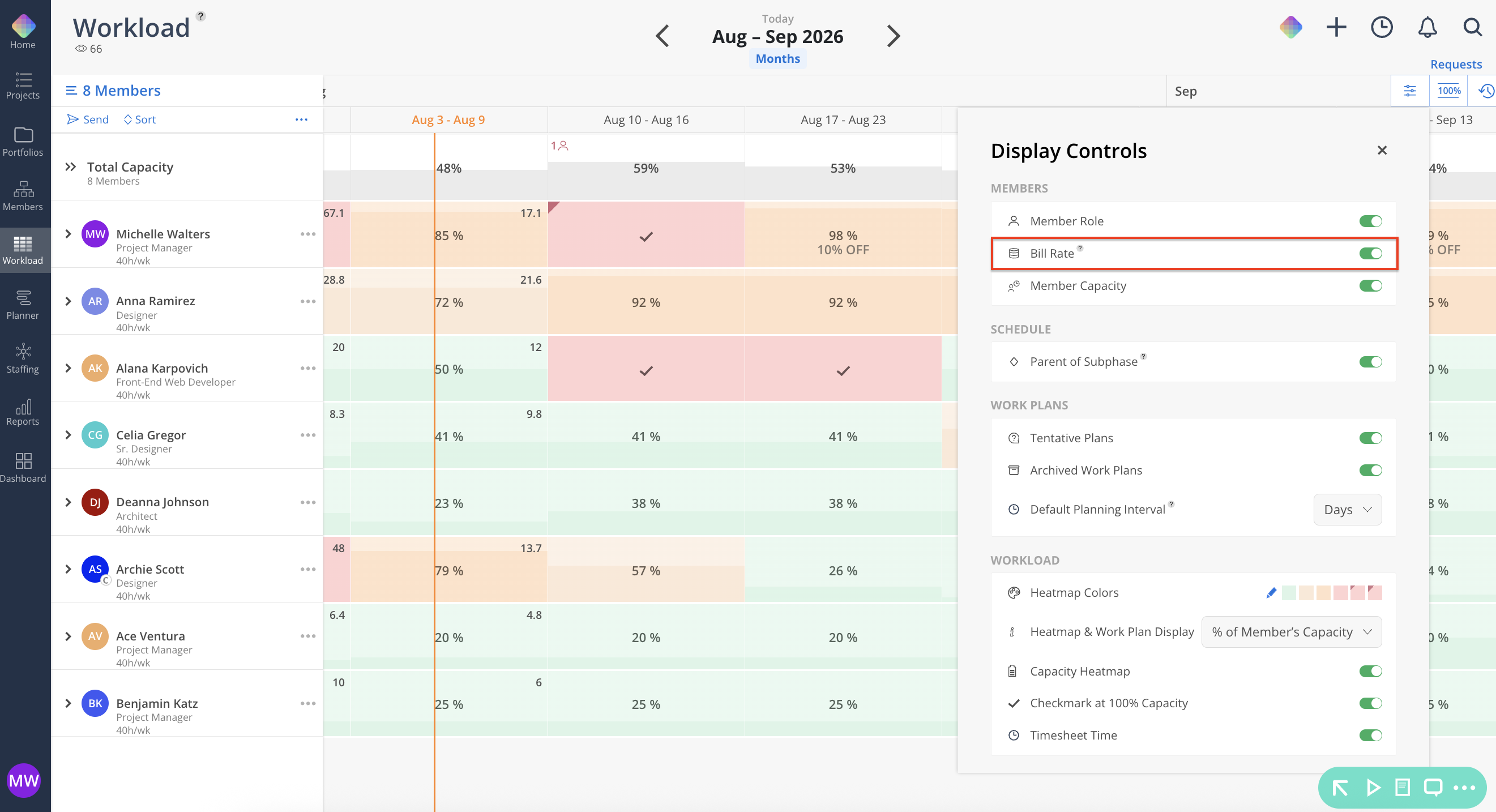

  2. Enable Bill Rate to show rates under member names. The actual number requires one additional click to reveal — a deliberate safeguard when you are screen sharing.

  3. Enable Timesheet Time to show synced actual hours in the corner of each heat map cell, so planned and actual sit side by side.

👉 Display Settings

3. Review a project's budget

  1. Open the project and click the Budget tab.

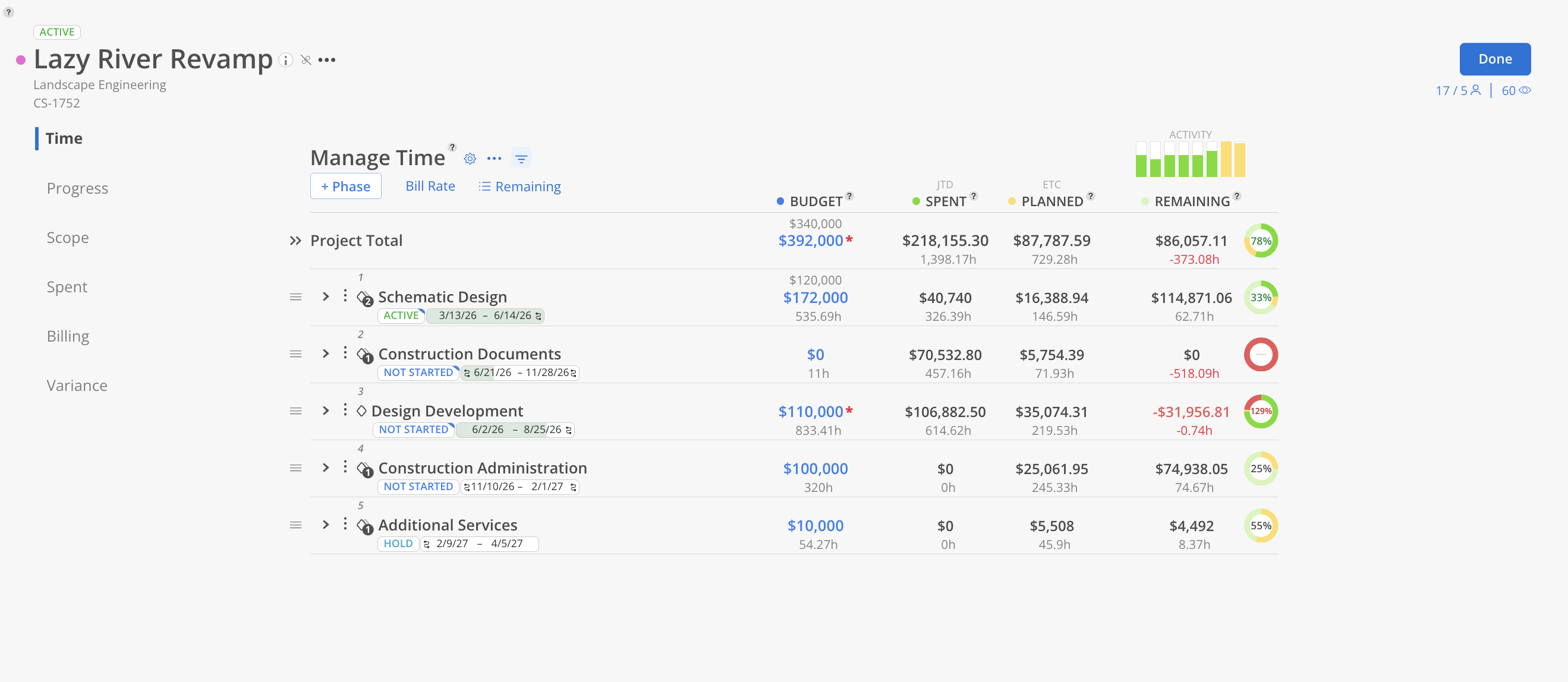

  2. Review the budget by phase and by member, with planned versus spent time and overall burn rate.

  3. Cross-reference against the Plan tab to see whether the schedule still supports the budget.

4. Watch planned against spent

The timesheet numbers in the Workload heat map and the Timesheet widget on each member's Home Space both draw from ERP-synced actuals. Compare them to planned hours to catch a phase burning faster than its schedule.

Turn timesheet time off during forward planning sessions — it adds clutter — and back on when reviewing actuals.

👉 Workload Settings

5. Use rate visibility in staffing decisions

When you are choosing between available members, bill rate is visible alongside availability in Workload. Filter by skill to narrow the candidate pool, then weigh rate against availability.

👉 Member Selection & Filtering

6. Set your heat map to the leadership view

Budget Managers and leadership generally prefer % of capacity as the heat map display value — it answers "how much of what we're paying for is committed" at a glance. Set it from the gear icon in Workload.

👉 Workload Settings

Links to Other Spaces

Space:

Your Access:

Home Space

Full

Projects

Full, including Budget and Scope tabs

Workload

Full, including bill rate visibility

Planner

Full

Budget

Full financial view including dollar amounts

Tips

  • The budget is downstream of the schedule — If the numbers look wrong, check the work plans first. Budget math follows from hours, and hours come from plans your PMs build

  • Reveal rates deliberately — The extra click on bill rate exists so you don't expose compensation data mid-screen-share.

  • Milestones carry no budget — If a date needs a budget line, it needs to be a phase, not a milestone. This is the most common structural mistake

  • Coach your Work Planners on the lock — A plan locked on total hours spread across a longer date range gets thinner, not bigger. That distinction shows up directly in your burn rate
