company logo

Help Center

Go to Mosaic
All collectionsReports SpaceDetailed OverviewsTime Budget Tracking Report

Time Budget Tracking Report

Compare spent time, planned time, and remaining budget across multiple projects in one view, with the ability to toggle between EAC and Remaining perspectives

Overview

This report mirrors the Budget space but lets you view multiple projects at once. It supports two view modes — Estimate at Completion (EAC) and Remaining — and lets you toggle between currency and hours, as well as between different bill rate types. The dollar sign icon on each project row links directly to the Budget space for that project.

When To Use This Report

Use the Time Budget Tracking Report when you need to answer: "Across all my projects, how does the combination of spent time and planned time compare to the budget and fee?" This is the report to use when you want a side-by-side budget comparison of multiple projects in one view, rather than clicking into each project's Budget space individually. It is ideal for portfolio-level budget reviews and financial check-ins with leadership.

What You See

The Bars

  • Green = spent time

  • Yellow = planned time (from today forward)

  • Light green = remaining budget

  • Hashed yellow = tentative planned time

Columns & Indicators

  • EAC column = total Estimate at Completion (spent + planned) for each project or phase

  • Budget column = budget set for the project or phase, with fee and percentage used shown below

  • Red exclamation mark (!) = project or phase is projected to exceed its budget

Controls

  • EAC / Remaining toggle — switch between seeing total projected spend or what is left

  • Currency / Hours toggle — switch the unit of display

  • Eye icon — hide rows with zero values

  • Filter icon — narrow results by specific criteria

  • Three-dot menu — export options

  • Budget link ($) — jump to the Budget space for any project

Summary Widget

The card in the top right totals the projects currently in view.

  • Budget — the combined budget of the projects in view

  • Fee — the combined project Fee, the same second-line figure each row shows in its Budget column. Fee is a reference figure: it has no checkbox, no colour on the gauge, and no percentage.

  • Spent, Planned and Remaining — each with its share of Budget. Total is always Spent + Planned + Remaining.

Understanding the Budget Column

The Budget column shows the total budget amount. Below it, you may see a second line showing the original fee and a percentage (e.g., $80,000 | 149.9%). This percentage indicates how much of the fee the EAC represents — anything over 100% means the project is projected to exceed its fee.

Bill Rate Options

  • Rate — uses the standard billing rate for calculations

  • Bill — uses the bill rate assigned to the project or member

  • Cost — uses the cost rate (restricted to admins and budget managers, indicated by a lock icon)

Report Views

This report has 2 views: Project, Member. Each view shows the same underlying data organized from a different starting point.

Project View

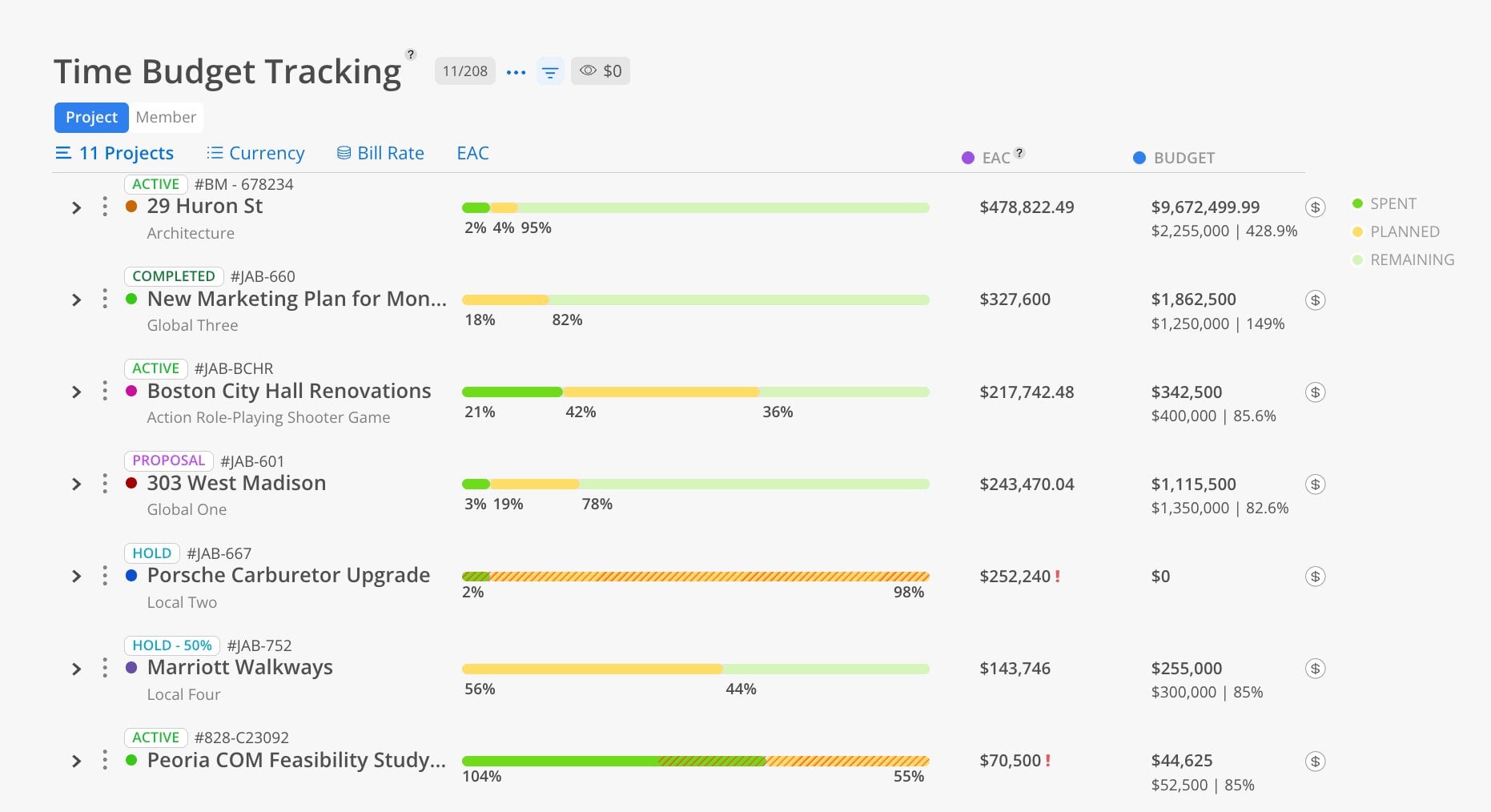

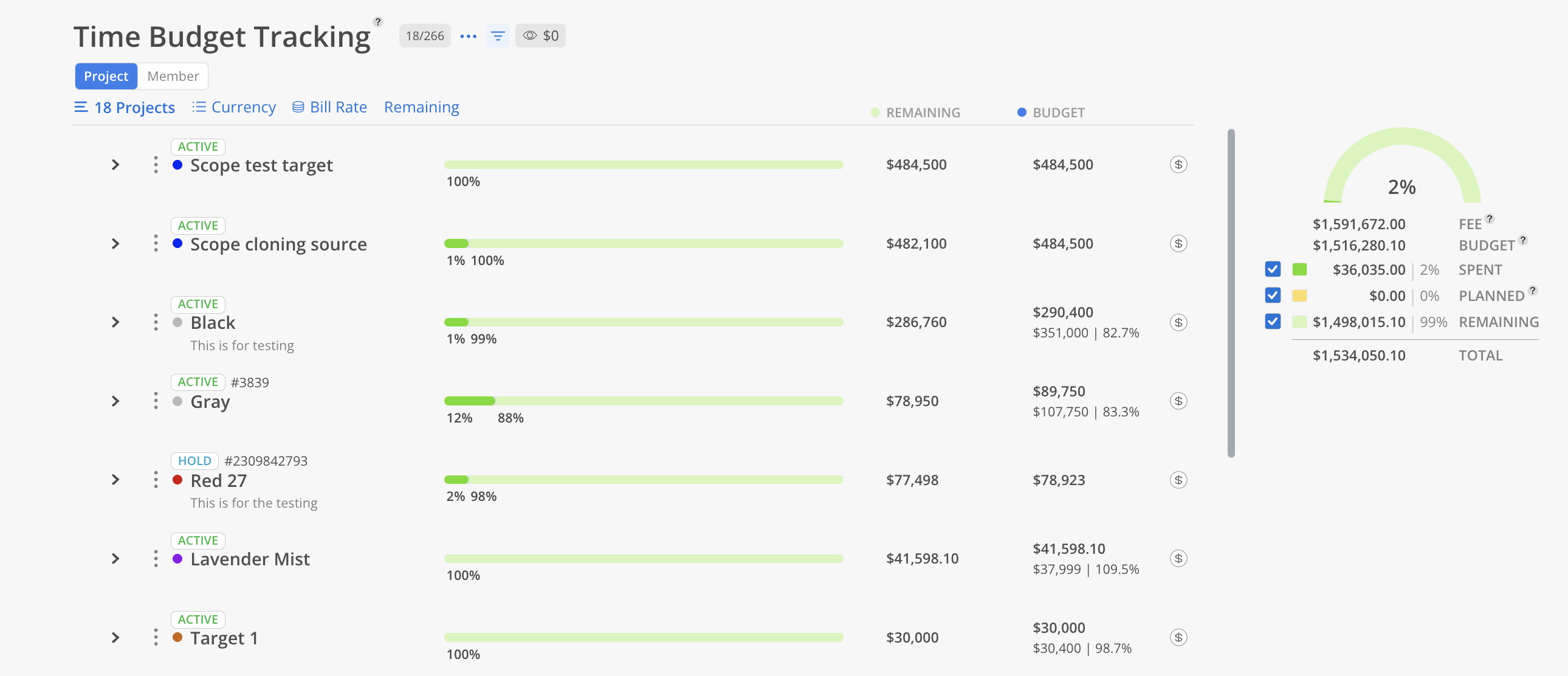

When in the Project tab, each project row displays:

  • Spent (green bar) — hours or dollars already logged from the past

  • Planned (yellow bar) — hours or dollars planned from today forward

  • Remaining (light green bar) — budget that has not yet been spent or planned

  • Percentage indicators — show the proportion of spent, planned, and remaining within the bar

  1. Click the Project tab at the top.

  2. Select projects by name, number, or portfolio.

  3. Toggle between EAC and Remaining using the view dropdown.

  4. Toggle between Currency and Hours.

  5. Click the Bill Rate dropdown to choose between Rate, Bill, or Cost.

Expand a project to see each phase underneath. Each phase shows its own bar, EAC, and budget. Phases display their status (e.g., Not Started), phase dates, and dependency icons.

Member View

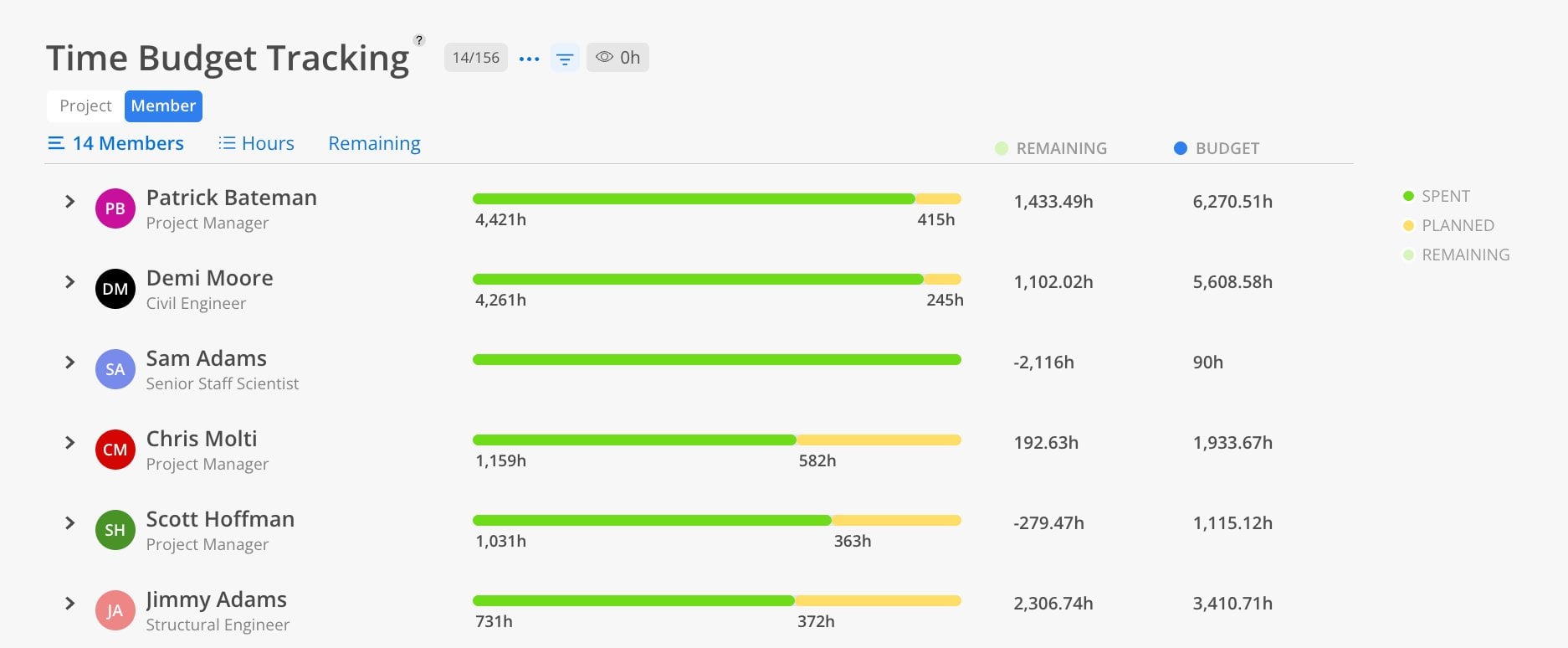

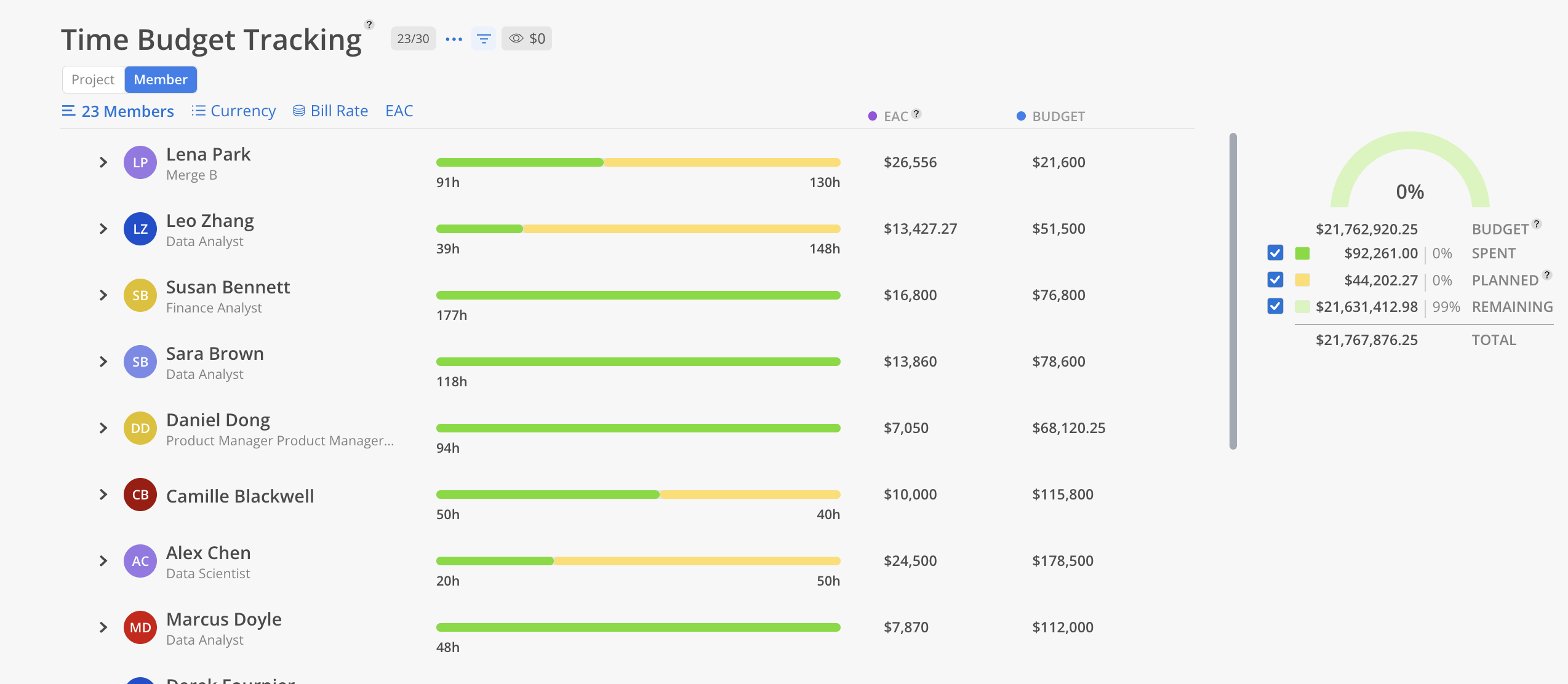

When in the Member tab, each member row displays:

  • Total spent and planned across all their projects

  • EAC and Budget totals for that member

  1. Click the Member tab at the top.

  2. Select members.

  3. Toggle between EAC and Remaining.

  4. Toggle between Currency and Hours.

Expand a member to see each project they are assigned to. Each project row under the member shows its status, project number, spent/planned bar, EAC, budget, and the budget link ($) icon. Red exclamation marks flag projects where the member's EAC exceeds the budget.

Tips

  • Use the Member tab for individual accountability — Quickly see which members are driving over-budget situations across their projects.

  • Check the percentage under Budget — When it exceeds 100%, that project's EAC is projected to exceed the fee.

  • Enter budgets for all projects — Projects without budgets entered will not show meaningful data in this report.
