company logo

Help Center

Go to Mosaic
All collectionsReports SpaceDetailed OverviewsRole Demand Report

Role Demand Report

Forecasts demand for specific roles based on current work plans and team capacity.

Overview

This report helps you determine whether you have enough staff in each role to cover planned work. It requires default roles to be set in admin settings for each member. Without default roles, the report will not populate fully.

When To Use This Report

Use the Role Demand Report when you need to answer: "Do we have enough people in each role to cover the work that is planned — and if not, do we need to hire?" This report is essential for proactive staffing decisions. Look at it 2–3 months ahead to identify roles that will be over-committed before it becomes a crisis.

What You See

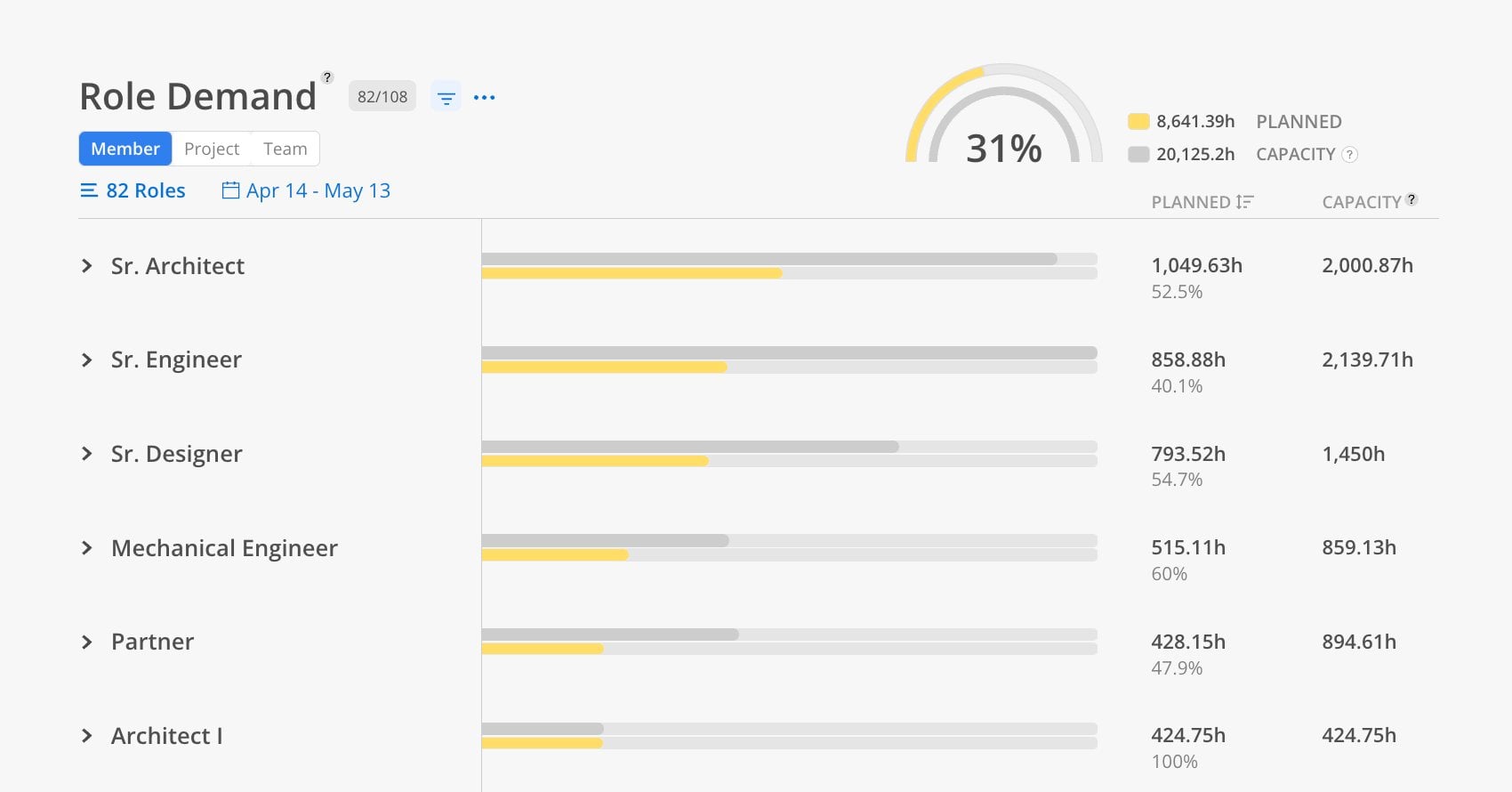

The Bars

  • Yellow = planned hours for that role

  • Gray = total working capacity for members in that role

  • Hashed yellow = open role / placeholder planned time

  • Red line = planned time exceeds capacity

Controls

  • Role selector — choose which roles to analyze

  • FTE toggle — switch from hours to full-time employee equivalents

  • Tentative toggle — include or exclude tentative work plans

  • Date range selector — 30 days, 3 months, or custom

Report Views

This report has 3 views: Member, Project, Team (Chart). Each view shows the same underlying data organized from a different starting point.

1. Member View

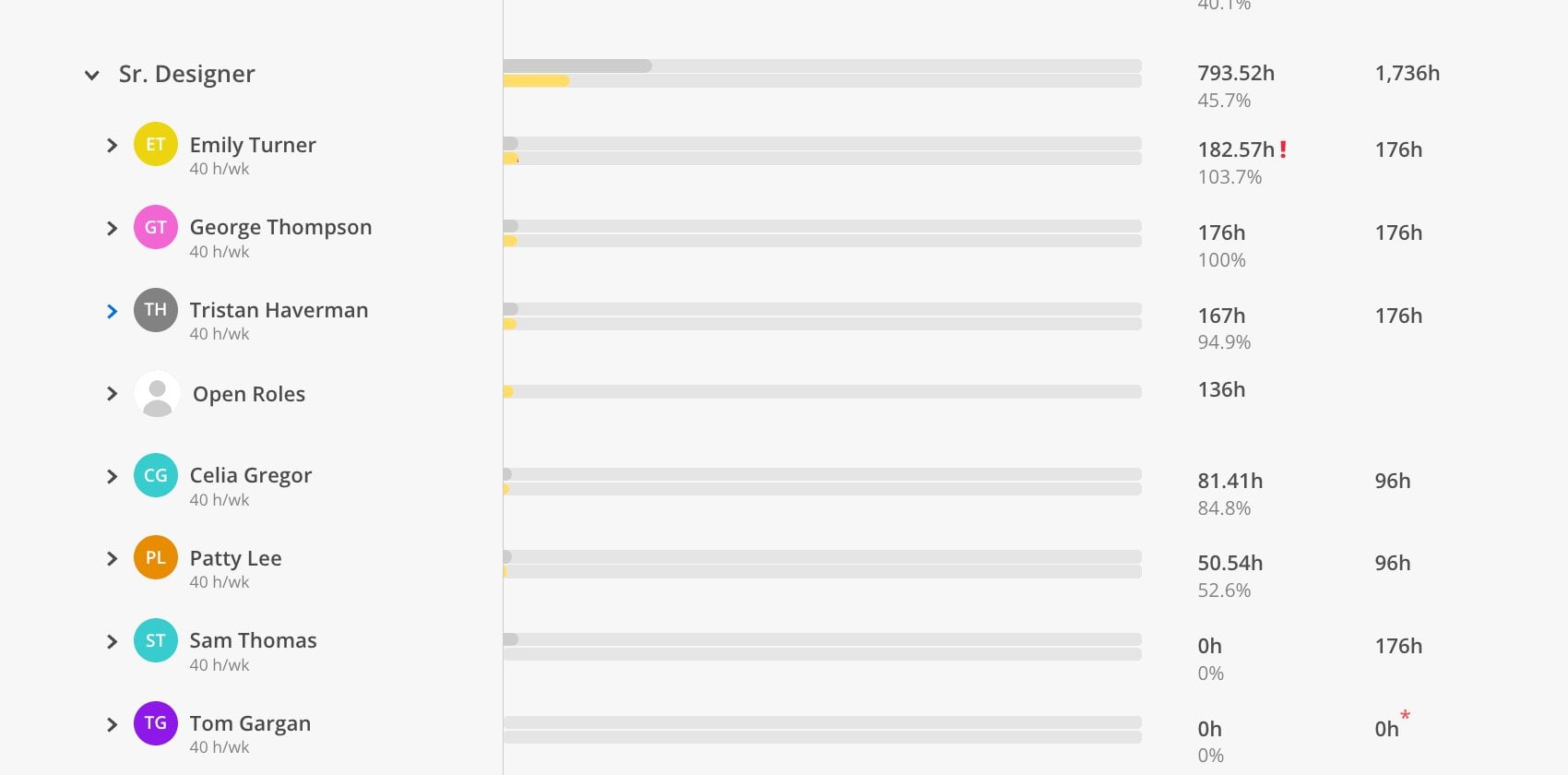

The Member view shows individual team members within each selected role.

  1. Click the Member tab at the top.

  2. Select roles using the role selector.

  3. Choose a date range (30 days, 3 months, custom).

Each member in the selected role appears with their planned time vs. capacity. If any member's planned time exceeds their capacity, a red indicator appears. The Open Roles row shows any placeholder plans that have not been assigned to a specific person.

2. Project View

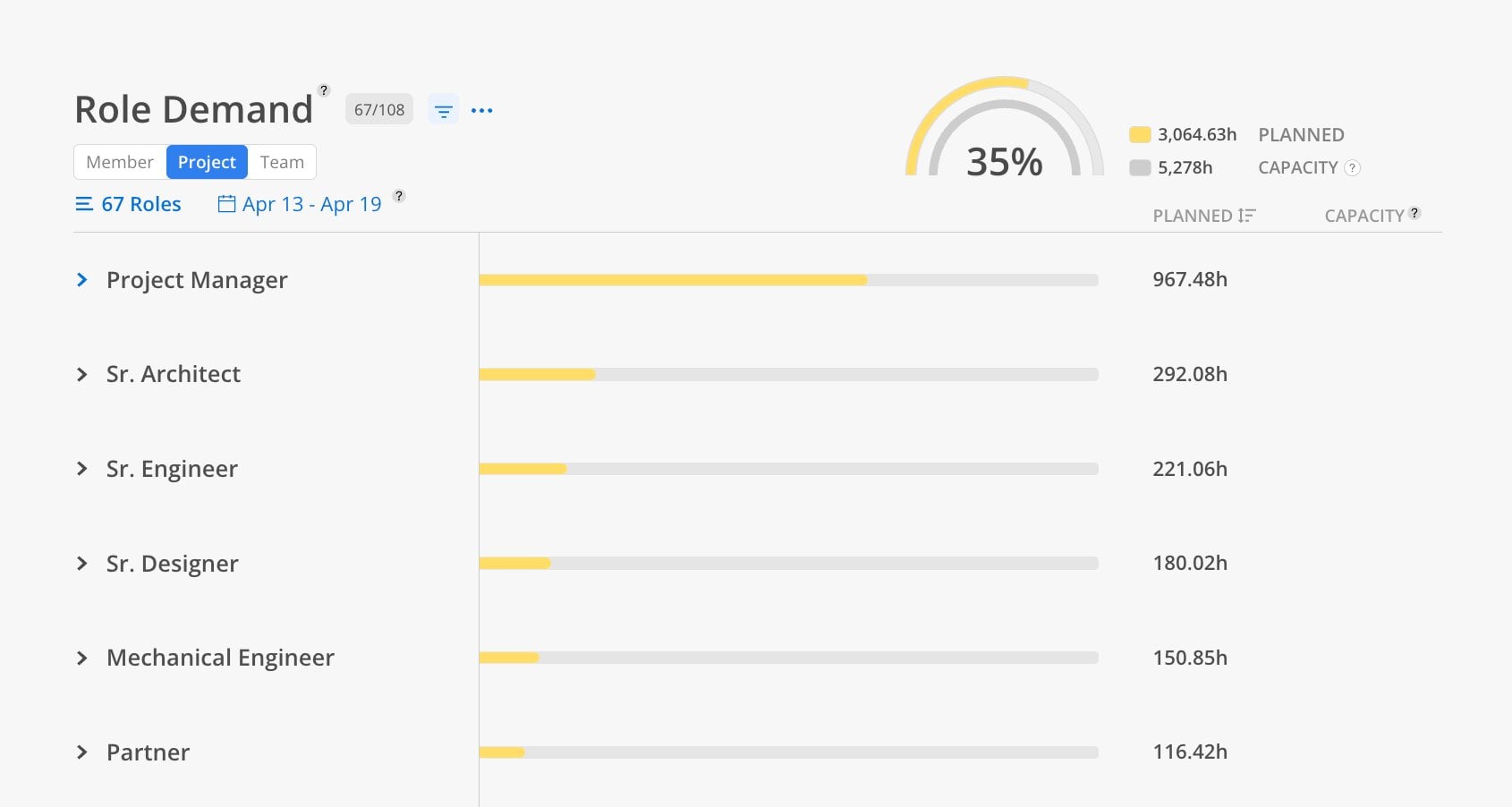

The Project view shows which projects are driving demand for each role.

  1. Click the Project tab at the top.

  2. Select roles.

  3. Choose a date range.

Each project shows how many hours of that role are planned. This helps identify which projects are consuming the most capacity for specific roles.

Team View

The Team view provides a chart summarizing role demand across the organization.

  1. Click the Team tab at the top.

  2. Select a role and choose Quarter or Annual view.

  3. If the yellow (planned) line exceeds the gray (capacity) line, that role is over-committed.

  4. Toggle to FTE to see how many additional employees would be needed.

  5. Toggle tentative and open role hours on or off to adjust the calculation.

Hover over any point in the chart to see the exact hours of planned time vs. capacity. When over-committed, a red bar or line shows the overage.

Did this answer your question?
😞
😐
😁
